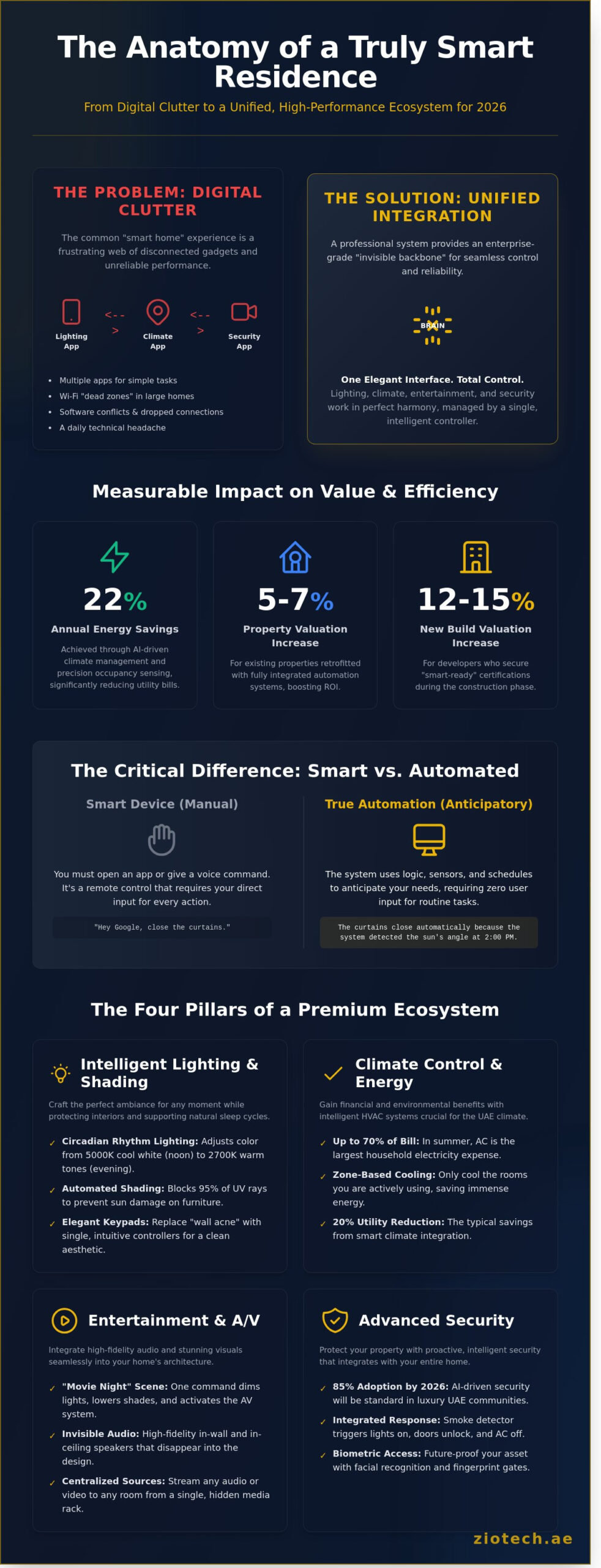

Smart Home Solutions: The Ultimate Guide to Integrated Living in 2026

The most expensive mistake in home automation is involving the integrator too late. Every week that passes after a UAE villa’s structure is poured without a confirmed automation infrastructure plan increases the cost of the final result — and decreases its quality. Retrofitting conduit through finished walls, surface-mounting cables across marble floors, and compromising on device locations because the backboxes were never installed: all of these are avoidable with planning that begins at the right stage.

This guide is for homeowners and project managers on new-build UAE villas and properties under fit-out — explaining what needs to be decided, when, and how to coordinate the automation infrastructure alongside the MEP, joinery, and interior design works.

Why Integrated Smart Home Planning Must Begin at the Design Stage

Unlike furniture or lighting fixtures that can be selected and installed after completion, smart home infrastructure is embedded in the building fabric. Once walls are plastered, floors are tiled, and ceilings are finished, the window for cost-effective infrastructure installation has closed.

The consequences of late involvement include:

  • Surface cabling: Cable runs in plastic trunking across finished walls and ceilings — visually poor, impossible to fully conceal in marble or stone environments
  • Compromised device locations: Keypads where cable runs allow, not where the designer specifies; touchscreens in visible cable locations rather than architecturally considered positions
  • Missing zones: Rooms that cannot be automated because the access void has been closed, or because cabling capacity was not pre-planned
  • Higher retrofit cost: Chasing cable runs through concrete after completion costs 3–5x more than installing conduit during construction

A reputable home automation company in Dubai will insist on being involved from the design stage — not to drive up project scope, but because early involvement is the only way to deliver a result that meets the standard of the property.

The Three Construction Phases of Smart Home Integration in UAE Villas

Phase 1 — Structure Stage (Before Walls Close)

This is the most critical phase. All conduit runs, backboxes, and cable pathways must be established before concrete is poured and walls are built. The automation engineer works from architectural drawings to plan:

  • Conduit routes: All conduit runs for data cabling (Cat6A), KNX bus cable, speaker cable, HDMI/video cable, and power distribution. In UAE concrete construction, PVC conduit is embedded in the slab or block walls during the structure phase.
  • Backbox positions: Every keypad, touchscreen, in-wall speaker, sensor, and device position must be confirmed — boxes embedded in the wall during construction, finished flush with the wall surface.
  • Cable pathways to network room: All cable routes must terminate at a central network/AV rack location — typically a dedicated room or large built-in cabinet. The pathway from this room to every area of the property must be planned and conduit-installed at structure stage.
  • Speaker cable runs: All in-ceiling and in-wall speaker locations confirmed with the interior designer, speaker cable pre-run before ceiling boards are installed.
  • Screen and projector positions: All HDMI, control, and power conduit for displays and projectors — including in-ceiling conduit for projector lifts in cinema rooms.

Coordination required at Phase 1: automation engineer + structural engineer + MEP consultant + main contractor. The automation engineer must provide a detailed drawing set for the MEP consultant to incorporate into the MEP drawings.

Phase 2 — Fit-Out Stage (After Plastering, Before Decoration)

After plastering is complete and before decoration, painting, joinery installation, and floor finishes, the fit-out stage of automation infrastructure begins:

  • Cable installation: All Cat6A, KNX bus cable, speaker cable, and video cable is pulled through the pre-installed conduit. All cables are labelled and tested at this stage.
  • Device installation: Lighting control modules, KNX actuators, and HVAC control modules are installed in distribution boards or dedicated automation panels.
  • Speaker back-cans: In-ceiling speaker frames (cans) are installed before ceiling painting — the speaker grille and driver are fitted after decoration to avoid damage.
  • Network rack installation: The main network rack, patch panels, managed switches, and AV matrix equipment are installed in the designated network room.
  • Projector and screen mechanics: Motorised projector lifts, screen mechanisms, and AV rack equipment in cinema rooms are installed before joinery completion — so joinery can be built around equipment, not vice versa.

Coordination required at Phase 2: automation engineer + joinery contractor + interior designer + MEP contractor. The joinery must be designed to accommodate automation panels, touchscreens, and AV rack openings — confirmed in writing with dimensions before cabinet manufacture.

Phase 3 — Commissioning Stage (Before Handover)

With all infrastructure in place and the property nearing completion, the commissioning phase begins:

  • Device fitting: Keypads, touchscreens, in-ceiling speakers (drivers and grilles), blind motors, and all end-devices are installed.
  • System programming: The control system is programmed — scenes defined, schedules set, AV integration configured, security system integrated. This stage typically takes 2–4 weeks for a luxury villa project.
  • Testing and snagging: Every device, every scene, every integration point is tested. Snagging items are resolved before client handover.
  • Client training and handover: The homeowner is walked through the system — every scene, the mobile app, the keypad operation. Full system documentation is provided. User accounts are set up in the homeowner’s name.

What to Decide Before Construction Starts

These decisions must be made before Phase 1 infrastructure begins — changing them after walls are built ranges from expensive to impossible.

Control Platform

KNX, Control4, Crestron, or hybrid? The platform choice determines the type of bus cable required, the size of distribution panels, and the network rack specification. This decision must be made before Phase 1 conduit is installed — KNX requires a specific 2-wire bus cable that is not interchangeable with standard data cabling.

All Room Locations and Intended Use

The automation engineer needs a confirmed room schedule: every room, its function, which systems will be in it (lighting zones, AV, HVAC zone, blind type, security), and the number of control points (keypads, touchscreens). Changes to room function after Phase 1 may require additional conduit runs.

Cinema Room Specification

The cinema room design must be confirmed before Phase 1 — including the projector type (ceiling-mounted or floor lift), screen size and position, speaker count and positions, acoustic treatment depth, and seating arrangement. Our home theatre design team works alongside the automation engineer to finalise cinema specifications before construction begins.

Security System Scope

The security system infrastructure — CCTV camera positions, door intercom locations, alarm panel location, smart lock positions, access control points — must be confirmed at Phase 1. CCTV cable runs (typically Cat6 or coaxial) and intercom cable runs must all be pre-conduit at structure stage.

Network Room Location and Size

The central network and AV rack room must be confirmed — typically 1–2m² of dedicated space with controlled temperature (AC is recommended for rack cooling), power circuits (with UPS backup for network equipment), and clear cable pathways to all areas of the property.

Outdoor Scope

Pool automation, outdoor lighting, outdoor audio, and irrigation control — all requiring conduit runs from the network room to outdoor areas. These must be embedded in landscaping foundations or terrace screeds, which are poured during construction. Outdoor conduit cannot be practically retrofitted into completed terraces without breaking up the finishes.

MEP Coordination — What the Automation Engineer Provides

In a well-managed UAE villa project, the automation engineer provides the MEP consultant with:

  • Automation conduit and cabling drawing set (floor plans showing all conduit routes)
  • Device schedule (full list of all devices with power requirements, cable types, and backbox sizes)
  • Network room specification (rack dimensions, power requirements, cooling requirements)
  • HVAC integration requirements (BACnet gateway locations, thermostat backbox positions)
  • Lighting control panel schedule (location, size, and supply requirements for all lighting control distribution boards)

This documentation allows the MEP consultant to incorporate all automation infrastructure into the official MEP drawings — ensuring all conduit runs are included in the main contractor’s scope and that no coordination gaps exist between trades.

Common Planning Mistakes on UAE Smart Home Projects

Mistake 1 — Deciding the Automation Scope After Appointment

Homeowners who hire an automation company after the MEP drawings are already approved must retrofit decisions into a plan not designed for them. Conduit runs may need to be added as late variations — at premium cost. Confirm automation scope before MEP design begins.

Mistake 2 — Treating Automation as an Afterthought of the AV

Many homeowners think of automation only in terms of the AV system — the cinema room and the TV. The far greater benefit of a properly planned system is the whole-property integration: climate, security, lighting scenes, blind automation. AV integration is one element of a full automation system — not the definition of it.

Mistake 3 — Not Confirming Device Locations with the Interior Designer

Keypad and touchscreen positions must be agreed between the automation engineer and the interior designer before Phase 1 backboxes are embedded. A keypad installed where the cable runs allows, rather than where the designer specifies, may conflict with joinery, furniture placement, or wall art.

Mistake 4 — Undersized Network Room

A luxury villa automation system requires a dedicated rack — typically 600mm × 600mm × 42U or larger, with power distribution, UPS, patch panels, managed switches, and AV matrix equipment. Projects that allocate a small cupboard for “the router” and then try to retrofit a full rack into it face significant problems. Design the network room from day one.

Mistake 5 — No Spare Conduit Capacity

Every conduit run should be installed with 30–40% spare capacity for future additions. Pre-install draw strings in all conduit runs so additional cables can be pulled without civil works. The cost of spare conduit at Phase 1 is negligible; retrofitting new conduit runs through a completed property is extremely expensive.

Frequently Asked Questions — Integrated Smart Home Design UAE

How early should I contact a home automation company for a new-build UAE villa?

At the architectural design stage — ideally before the MEP drawings are issued for approval. The automation engineer needs to coordinate conduit runs with the MEP consultant, confirm backbox positions with the architect, and provide a device schedule before construction begins. Contact a home automation company in Dubai as soon as your architect begins the MEP design process.

Can I add smart home automation to a UAE villa that is already under construction?

Yes — but cost and quality depend on how far construction has progressed. If walls are still open (structure complete, plastering not yet started), most infrastructure can still be installed at reasonable cost. If plastering is complete, all cabling must be surface-run or chased through finished walls — significantly more expensive and visually compromised. A site visit from an experienced integrator will confirm what is still achievable at your project’s current stage.

What is the typical timeline for a new-build villa automation project in Dubai?

Phase 1 (infrastructure): runs concurrently with construction — typically 3–12 months depending on villa size and build programme. Phase 2 (fit-out): 2–4 weeks concurrent with the main fit-out phase. Phase 3 (commissioning): 3–6 weeks before handover. Total elapsed time from first engagement to handover commissioning: typically 6–18 months on new-build projects.

How do I ensure the automation engineer and MEP consultant coordinate correctly?

Require the automation company to produce a formal automation drawing set (AutoCAD or Revit format) that can be incorporated into the MEP drawings. Schedule a joint coordination meeting between the automation engineer, MEP consultant, and main contractor before Phase 1 begins. Confirm in writing which trade is responsible for which installation elements — automation company or MEP contractor — to avoid gaps and overlaps.

What power requirements does a home automation network room need?

A typical luxury villa network room requires: 2–4 dedicated 20A circuits for rack equipment, 1–2 UPS circuits (battery backup for network and automation equipment during power outages), and adequate cooling (a small dedicated split AC unit is recommended — rack equipment generates significant heat in a small enclosed space). These requirements must be included in the MEP electrical drawing from Phase 1.

Can smart home automation be integrated with a developer-installed system in an off-plan Dubai property?

Often yes — many UAE developers install basic automation infrastructure (conduit, backboxes, sometimes HDL or a simplified Control4 system) in off-plan villa and apartment projects. A specialist integrator can assess the existing infrastructure, upgrade or replace the control platform, and expand the scope significantly post-handover. A site survey confirms what is feasible and what the upgrade cost will be.

How does outdoor automation coordinate with the landscaping contractor?

The automation engineer must provide the landscape contractor with confirmed positions and power requirements for all outdoor devices: CCTV cameras, outdoor speakers, landscape lighting, irrigation control valves, pool equipment, and any outdoor touchscreens or keypads. All conduit runs must be embedded in foundations, planters, and terrace screeds before they are poured — not retrofitted after. A joint coordination meeting before landscaping begins is essential.
